Objective

This guide explains the complete process of creating a Subcontracting Jobwork Request in ManufApp. It helps users understand how to select the correct jobwork type, add vendor and item details, check material availability, include additional charges, submit the request for approval, and approve outward material before issuing it to the subcontracting vendor.


Step 1: Open Subcontracting Orders

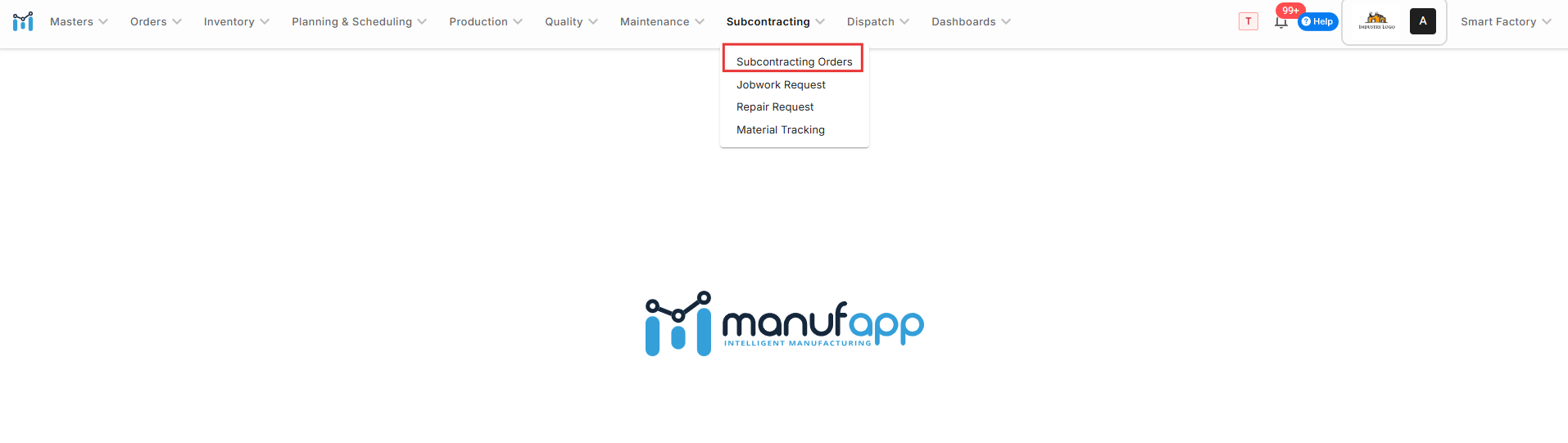

Go to:

Subcontracting → Subcontracting Orders

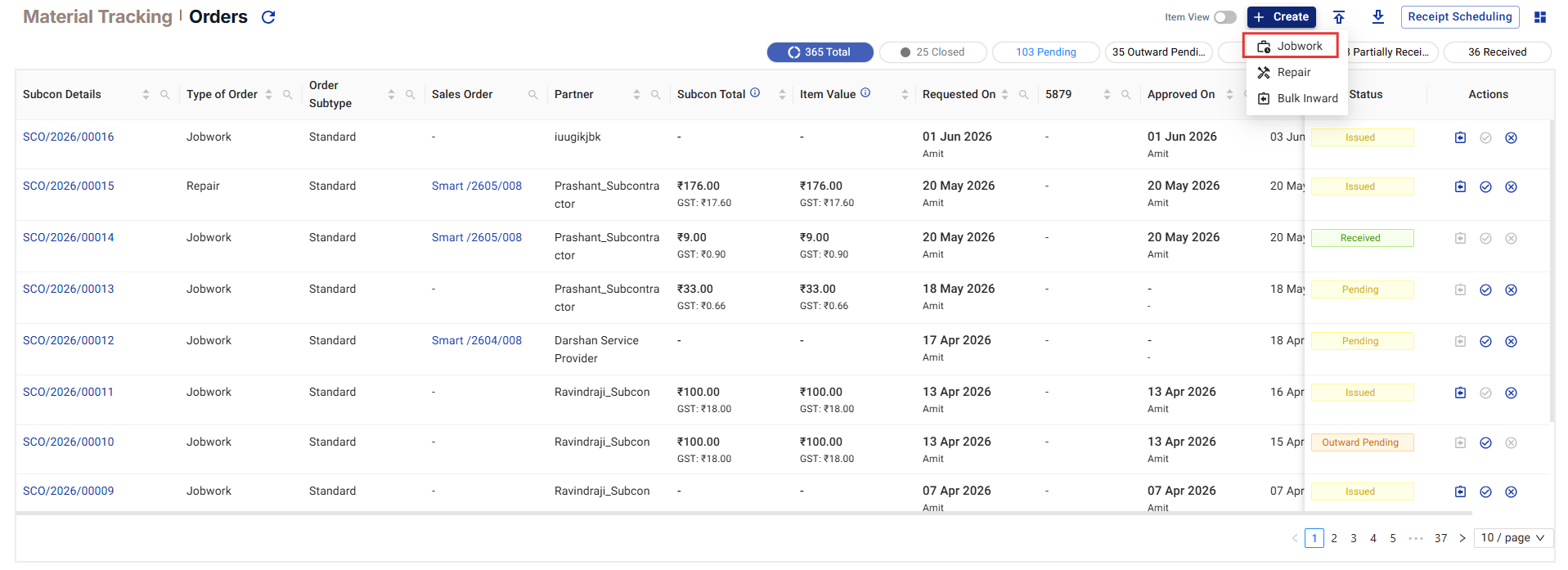

The Material Tracking | Orders page will open. Here, you can view all jobwork and repair orders with their vendor, item value, requested date, approved date, and status.


Step 2: Create Jobwork Request

Click:

Create → Jobwork

The Jobwork Request form will open.

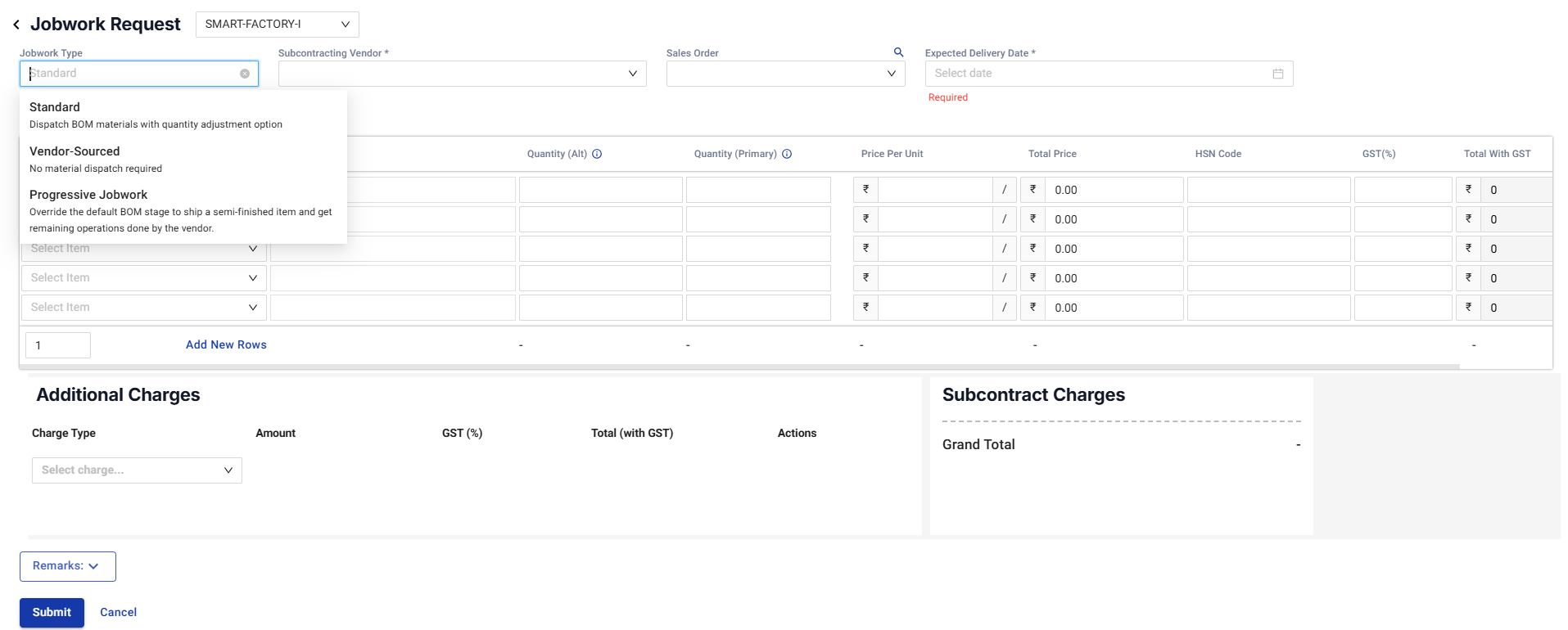

Step 3: Select Jobwork Type

Select the required Jobwork Type.

Common options are:

Jobwork Type

Meaning

Standard

Material is sent to vendor for jobwork

Vendor-Sourced

Vendor arranges the material

Progressive Jobwork

Semi-finished item is sent for next process

For normal subcontracting, select Standard.


Step 4: Fill Basic Details

Fill the required fields:

Field

Description

Subcontracting Vendor

Select the vendor

Sales Order

Link SO if required

Expected Delivery Date

Select expected return date

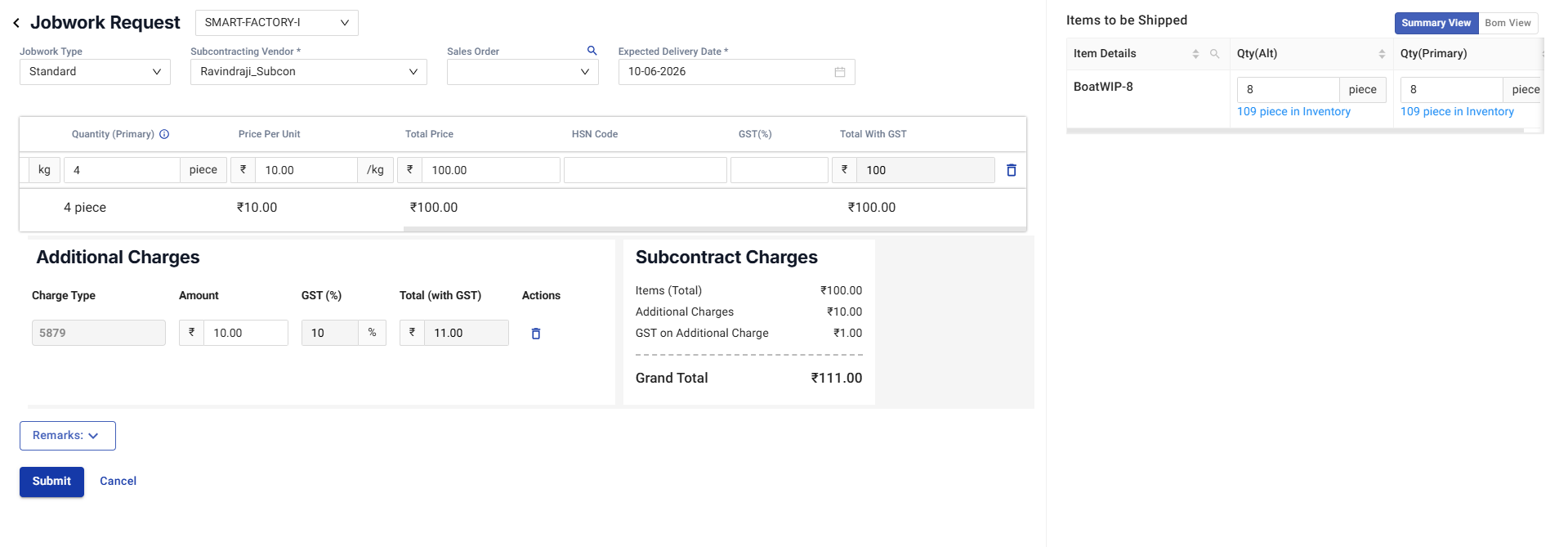

Step 5: Add Item Details

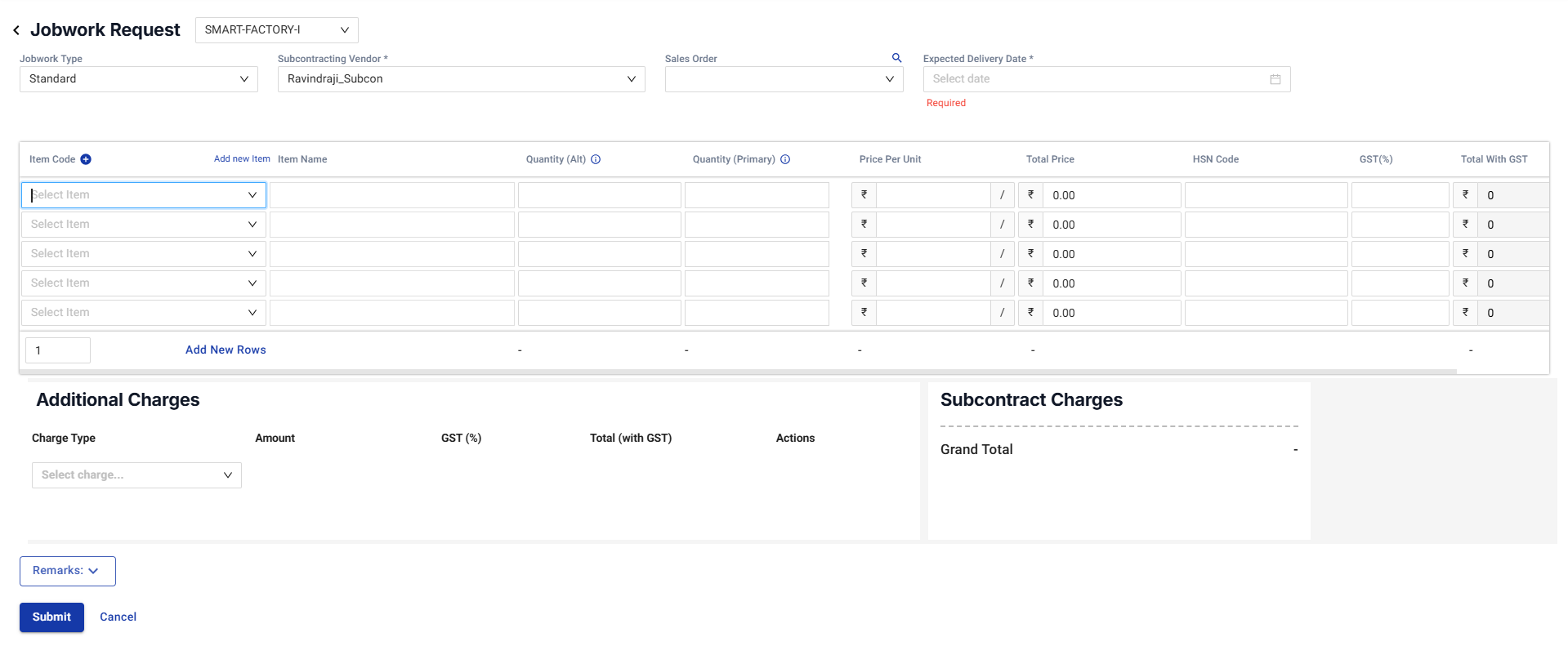

In the item table, select the item and enter:

Field

Description

Item Code

Select item

Quantity

Enter required quantity

Price Per Unit

Enter jobwork price

HSN Code

Add HSN if required

GST (%)

Add GST

Total With GST

Auto-calculated value

Use Add New Rows if more items are required.


Step 6: Check Items to be Shipped

On the right side, check Items to be Shipped.

This shows the item quantity and available inventory. Confirm that stock is available before submitting.


Step 7: Add Additional Charges

If needed, add extra charges like freight, handling, labour, or transport.

Fill:

Field

Description

Charge Type

Select charge

Amount

Enter amount

GST (%)

Enter GST

Total with GST

Auto-calculated

The Subcontract Charges section shows the final total.

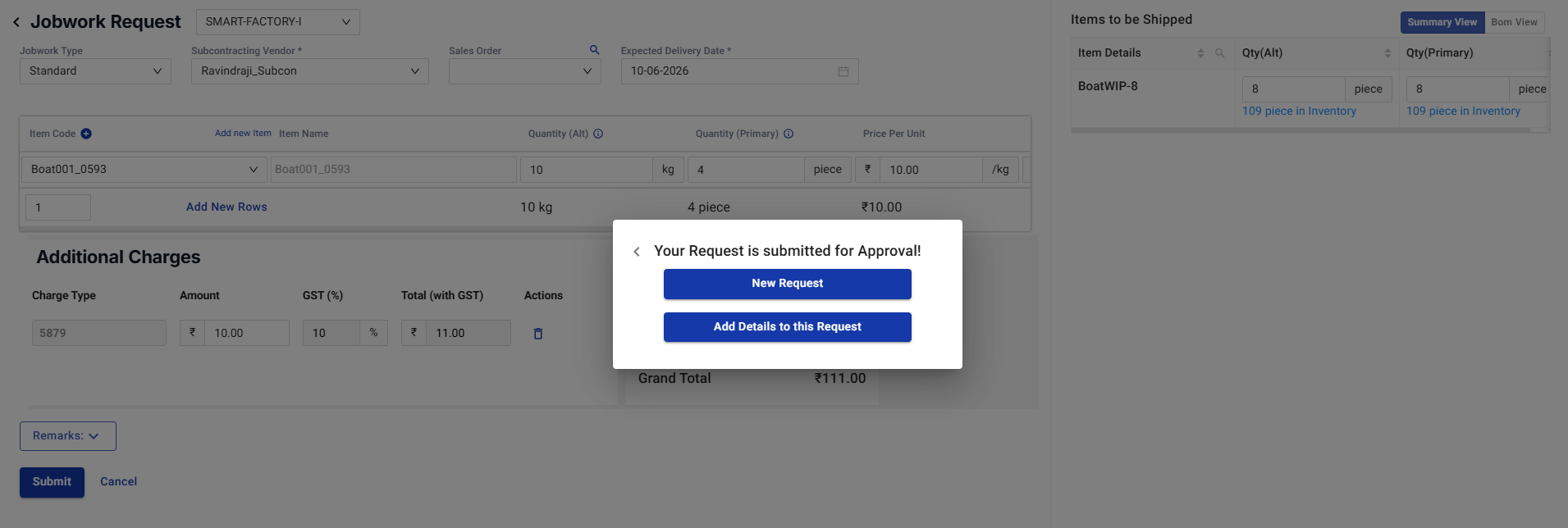

Step 8: Submit Request

Click Submit.

A confirmation popup appears:

Your Request is submitted for Approval!

After submission, the order appears in the list with status Pending.

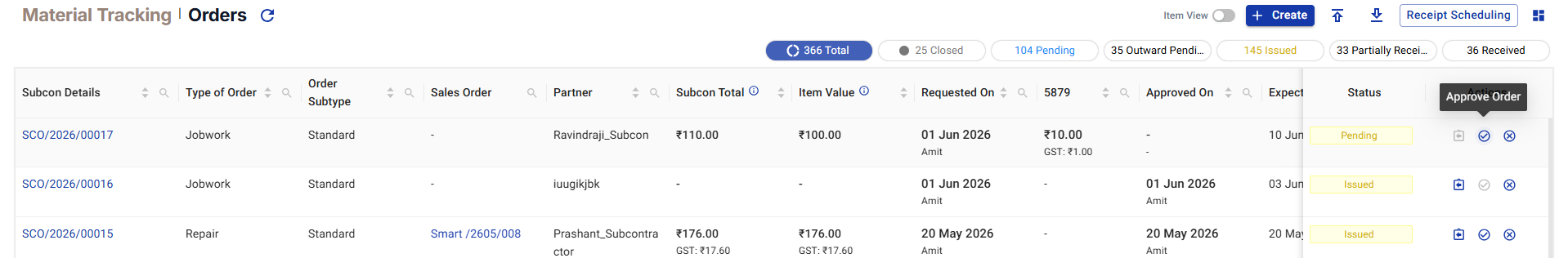

Step 9: Approve Jobwork Order

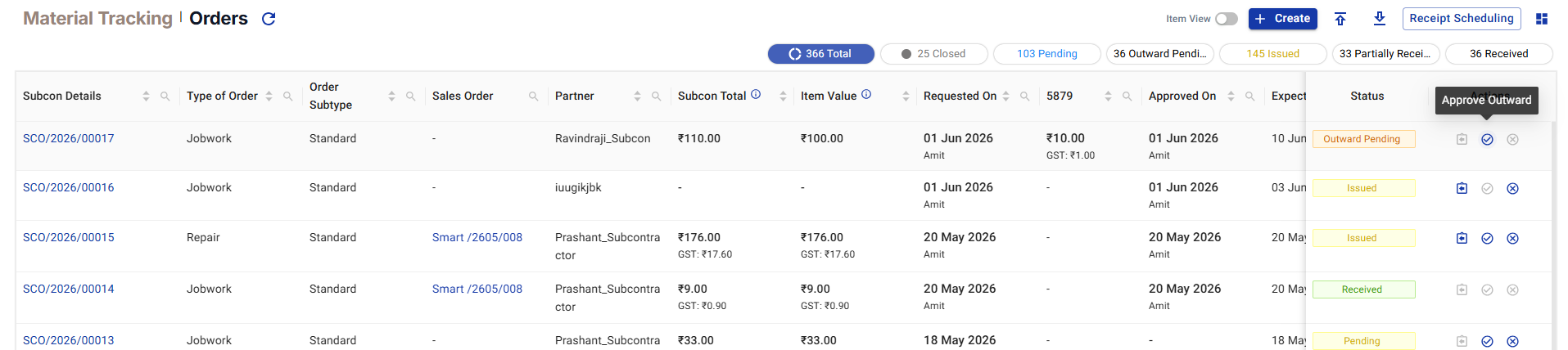

From the Material Tracking | Orders list, click the approval action.

The status changes from:

Pending → Outward Pending

This means the request is approved, but material outward is still pending.



Step 10: Approve Outward Material

Click the outward approval action.

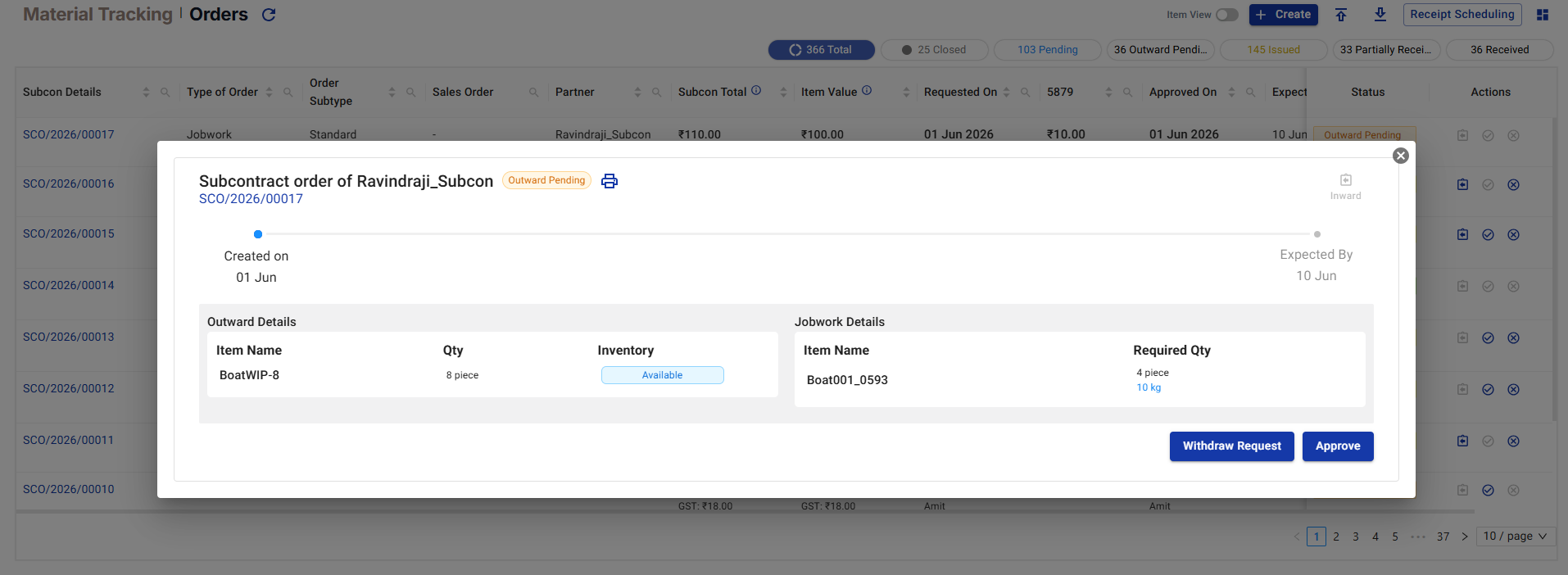

A popup opens with:

Section

Details

Outward Details

Item, quantity, and inventory availability

Jobwork Details

Required item and quantity

Review the details and click Approve.

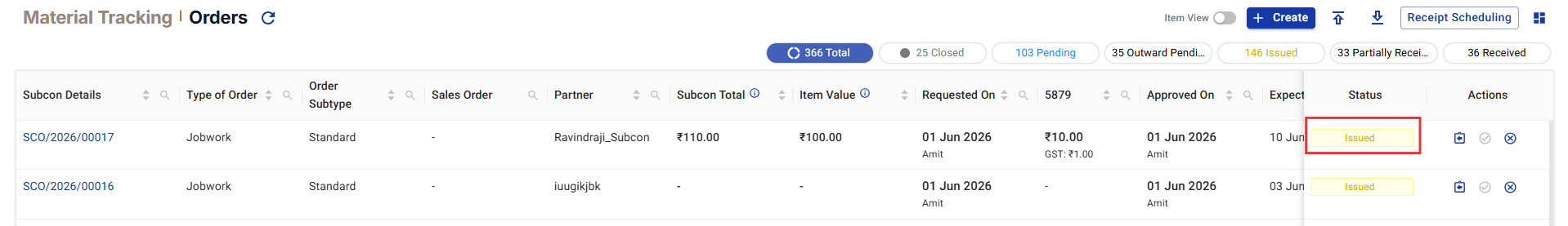

After approval, the status changes to Issued.


Conclusion

The Subcontracting Jobwork Request flow helps users manage the complete subcontracting process in a structured way. From request creation to outward approval, each step ensures that vendor details, item quantities, inventory availability, charges, and approval status are properly recorded. This improves material tracking, reduces manual follow-ups, and gives users clear visibility of jobwork orders from one screen.


    • Related Articles

    • Help Guide: Subcontracting Jobwork Inward with Set Deviation

      Objective This guide explains how to create an inward entry against an issued jobwork order and how to use Set Deviation when the received quantity differs from the item’s standard alternate unit conversion. Step 1: Add Alt Unit in Item Master Go to: ...
    • How to Create Inward Request Against Purchase Order in ManufApp

      Use this guide when materials are received against a pre-approved Purchase Order (PO) — ensuring consistency and traceability in procurement. For a quick overview, see: What is an Inward Request in ManufApp? Step 1: Navigate to Inward Request Go to: ...
    • How to Create Manual Inward Request (Without PO) in ManufApp

      Use this guide when materials arrive without a Purchase Order (PO) — such as local purchases, ad-hoc supplies, or unplanned receipts. For a quick overview, see: What is an Inward Request in ManufApp? Step 1: Navigate to Inward Request Go to: ...
    • How to Create a Warehouse Outward Request

      🎯 Objective To guide users through the process of creating a Warehouse Outward Request in ManufApp — enabling smooth transfer of materials between warehouses with complete traceability using invoice and truck details. This ensures real-time ...
    • How to Upload Subcontracting Orders via CSV

      🎯 Objective To enable users to bulk create subcontracting orders quickly and accurately by using a standard CSV template instead of manual entry. Step 1: Open Upload CSV Screen Go to Subcontracting → Subcontracting Orders. Click Upload CSV icon Step ...
